Grundfos · Variable Speed Submersible Well Pump
SPE 8 in
Variable speed stainless steel submersible pumps on the Grundfos MS6000P permanent magnet motor, for wells from 7.7 in to 7.7 in minimum borehole: 11 complete builds in the SPE 385S and 475S flow classes, 10 to 50 HP, run by a Grundfos CUE drive.
385-475 GPM Rated Flow
10-50 HP PM Motor
64-385 ft Nominal Head
4 and 6 in NPT Discharge
7.7 in Min. Borehole
460V 3Ph
CUE Drive Required
AISI 304 Stainless Steel
cCSAus
7.0 in Dia x 47.8-88.8 in L
159.0-299.2 lb Weight
What Ships and What It Needs to Run
Included: the SPE pump end and its Grundfos MS6000P permanent magnet motor, factory-assembled as one complete pump.
Variable frequency drive required, ordered separately. Every build runs from your 460V 3Ph supply through a drive with IPM motor control, such as the Grundfos CUE (NEMA 1 indoor) or CUE NEMA 4X (outdoor); the matching CUE for each build is in the Models & Ratings table. The motor runs only from the drive.
Sine-wave filter required, ordered separately. An IPM-ready sine-wave filter goes on the drive output; the matching filter for each build is in the Models & Ratings table.
Drop cable and splice kit: sized to your setting depth and ordered separately.
Overview
Grundfos SPE is a speed-controlled submersible pump system: the SP stainless steel pump end on a Grundfos MS6000P interior permanent magnet (IPM) motor, run through a variable frequency drive such as the Grundfos CUE. The drive matches pump speed to demand, so the pump holds a constant pressure, flow or level as the duty changes, and Grundfos rates the system for a low running cost in changing operating conditions.
The MS6000P is a 4-pole synchronous motor with the magnets embedded in a hermetically sealed rotor, a canned stator, silicon carbide shaft seal faces and heavy duty thrust bearings. Grundfos quotes 8-10% higher efficiency than an asynchronous motor of the same output, in a lighter, more compact motor. The motor runs at 3 × 410 V and up to 3600 rpm (120 Hz) from the drive.
Typical uses listed by Grundfos include water supply, irrigation, groundwater lowering, pressure boosting, fountains, mining and offshore applications. The CUE soft-starts the motor, protects the installation against water hammer and runs the predefined constant pressure, constant flow and constant level modes.
The one thing to plan for: an SPE motor cannot be connected straight to the power line. It needs a variable frequency drive with IPM motor control and an IPM-ready sine-wave filter, both sold separately; the matching Grundfos CUE drive and filter part numbers are in the Models & Ratings table.
Genuine Grundfos equipment, factory-new in original packaging — sold and supported by Watermain Supply, an independent industrial supplier.
Warranty
24 months from date of installation, but not more than 30 months from date of manufacture. In Grundfos's words, products are “warranted to the original user only to be free of defects in material and workmanship”; the full terms are in the installation and operating instructions on the Data Sheet tab.
Grundfos extends this to a 5-year system warranty when the SPE complete pump is purchased together with a Grundfos CUE drive (Grundfos US price list, January 2026).
Single Pump or a Set?
Each SPE serves one well, with its own CUE drive. The CUE supports duty and standby operation across two pumps; for a set, or a flow outside what one pump carries, send us the duty and we will size the pumps and drives with you.
Check the Part Number
The model code reads flow class, motor horsepower and stages: SPE385S400-4 is the SPE 385S (385 GPM class) on a 40 HP motor with 4 stages. The MS6000P comes in 10, 25, 40 and 50 HP executions; the pump power column shows the load each build places on it, which sets the CUE drive and filter size. In the selector, choose horsepower and motor size first, then voltage and phase, then the model, shown with its nominal head at rated flow and full speed. The part number for every build is in the Models & Ratings table.
Models & Ratings
| Model |
Part No. |
Motor HP |
Pump Power HP |
SF Amps |
CUE Drive, NEMA 1 Indoor |
CUE Drive, NEMA 4X Outdoor |
Sine-Wave Filter |
| SPE385S100-1 |
92673224 |
10 |
10 |
16.2 |
99616716 |
99619044 |
92617581 |
| SPE385S250-2 |
92673225 |
25 |
20 |
32.2 |
99616718 |
99619046 |
92617583 |
| SPE385S250-3 |
92673226 |
25 |
25 |
39.0 |
99616719 |
99619047 |
92617587 |
| SPE475S250-1 |
92673230 |
25 |
15 |
24.2 |
99616717 |
99619045 |
92617582 |
| SPE475S250-2 |
92673231 |
25 |
20 |
32.2 |
99616718 |
99619046 |
92617583 |
| SPE385S400-4 |
92673227 |
40 |
40 |
60.0 |
99616721 |
99619049 |
92617589 |
| SPE385S400-5 |
92673228 |
40 |
40 |
60.0 |
99616721 |
99619049 |
92617589 |
| SPE475S400-3 |
92673232 |
40 |
30 |
44.8 |
99616720 |
99619048 |
92617588 |
| SPE475S400-4 |
92673233 |
40 |
40 |
60.0 |
99616721 |
99619049 |
92617589 |
| SPE385S500-6 |
92673229 |
50 |
50 |
82.6 |
99616723 |
99619051 |
92617591 |
| SPE475S500-5 |
92673234 |
50 |
50 |
82.6 |
99616723 |
99619051 |
92617591 |
Part numbers, motor and pump power, service factor amps and the matching CUE drive and sine-wave filter: Grundfos US price list, effective January 1, 2026, which follows the easy-selection table in the Grundfos SPE data booklet. Drives and filters are sold separately. We confirm the drive and filter against your cable length and duty when you order.
Flow Classes
| Pump |
Rated Flow |
Discharge |
Min. Borehole |
Min. Submergence |
Motor |
Builds |
| SPE 385S |
385 GPM |
4 in NPT |
7.7 in |
8 ft |
10-50 HP |
6 |
| SPE 475S |
475 GPM |
6 in NPT |
7.7 in |
8 ft |
25-50 HP |
5 |
Source: Grundfos SPE data booklet, May 2026 (recommended minimum borehole with standard connections; minimum submergence per pump table) and Grundfos Product Center (discharge).
Shared Specifications
| Specification |
Value |
| Motor |
Grundfos MS6000P 6 in interior permanent magnet (IPM) motor, 4-pole synchronous, 10, 25, 40 or 50 HP execution |
| Motor supply |
3 × 410 V at 120 Hz from the drive (460V 3Ph CUE drive input), 1650-3600 rpm |
| Drive |
Variable frequency drive with IPM motor control required, for example Grundfos CUE; IPM-ready sine-wave filter required |
| Control modes (CUE) |
Constant pressure, constant flow, constant level |
| Liquid temperature |
Up to 140°F (60°C) with 0.5 ft/s flow past the motor |
| Max. operating pressure |
870 psi |
| Flow range |
0.1 to 1.3 × rated flow for continuous running |
| Max. sand content |
SPE 385S: 50 ppm; SPE 475S: 50 ppm |
| Enclosure |
IP68 |
| Approvals |
cCSAus, with CULDWUS on most builds (Grundfos Product Center codes) |
| Curve tolerance |
ISO 9906:2012 Grade 3B |
| Included |
Pump end and MS6000P motor, assembled as one complete pump. CUE drive and sine-wave filter sold separately |
Performance — Will It Do What You Need?
The figure below is the nominal head Grundfos publishes for each model at its rated flow and full speed (3600 rpm): the total head the pump adds, in feet. Pick a model whose nominal head covers your pumping level plus the pressure you need at the surface (2.31 ft per psi) plus pipe friction; the CUE then trims the speed to hold your setpoint.
| Model |
Stages |
Motor HP |
Pump Power HP |
Nominal Head at Rated Flow, ft |
| SPE385S100-1 |
1 |
10 |
10 |
64 |
| SPE385S250-2 |
2 |
25 |
20 |
129 |
| SPE385S250-3 |
3 |
25 |
25 |
193 |
| SPE385S400-4 |
4 |
40 |
40 |
256 |
| SPE385S400-5 |
5 |
40 |
40 |
321 |
| SPE385S500-6 |
6 |
50 |
50 |
385 |
| SPE475S250-1 |
1 |
25 |
15 |
65 |
| SPE475S250-2 |
2 |
25 |
20 |
132 |
| SPE475S400-3 |
3 |
40 |
30 |
197 |
| SPE475S400-4 |
4 |
40 |
40 |
264 |
| SPE475S500-5 |
5 |
50 |
50 |
331 |

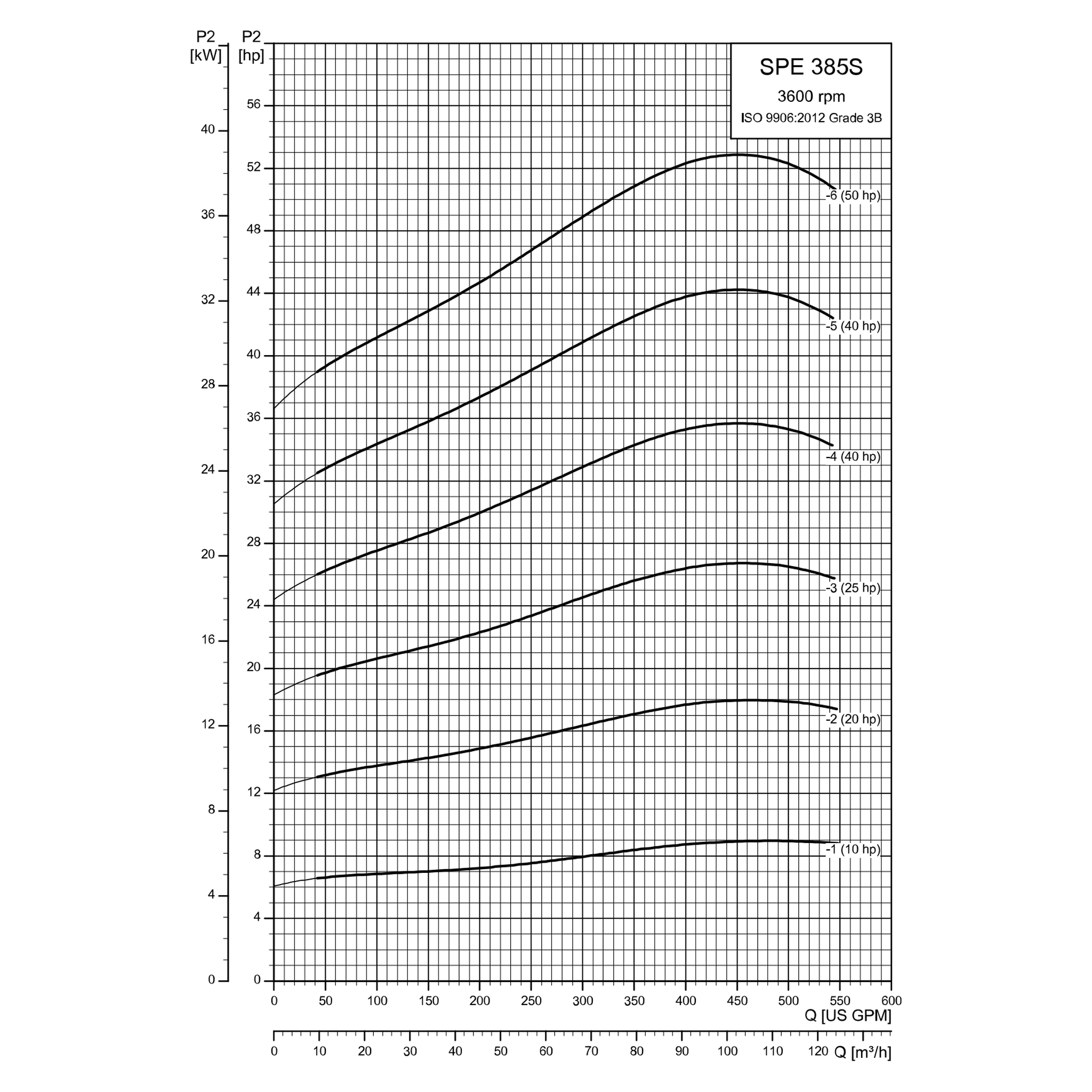

Source: Grundfos SPE data booklet, May 2026 (pump tables, 3600 rpm). Performance conforms to ISO 9906:2012 Grade 3B. The head and power curves for each flow class are in the product images, and the data booklet on the Data Sheet tab carries the full curves and tables.
Dimensions & Weights
| Model |
Overall Length, in |
Max. Diameter, in |
Net Weight, lb |
| SPE385S100-1 |
47.8 |
7.05 |
159.0 |
| SPE385S250-2 |
57.6 |
7.05 |
195.8 |
| SPE385S250-3 |
62.6 |
7.05 |
205.0 |
| SPE385S400-4 |
73.6 |
7.05 |
252.0 |
| SPE385S400-5 |
78.6 |
7.05 |
261.2 |
| SPE385S500-6 |
88.8 |
7.05 |
299.2 |
| SPE475S250-1 |
52.6 |
7.05 |
188.1 |
| SPE475S250-2 |
57.6 |
7.05 |
197.3 |
| SPE475S400-3 |
68.5 |
7.05 |
244.3 |
| SPE475S400-4 |
73.6 |
7.05 |
253.5 |
| SPE475S500-5 |
83.7 |
7.05 |
291.5 |
Source: Grundfos SPE data booklet, May 2026, matched by flow class and stage count. Max. diameter includes the cable guard and motor.
Before You Buy — The Limits That Decide the Fit
| Check |
What to confirm |
| Well size |
Casing ID at least the minimum borehole for the flow class, 6.1 in to 9.8 in (Flow Classes table) |
| Submergence |
At least the minimum submergence for the flow class (Flow Classes table) |
| Drive |
A variable frequency drive with IPM motor control is required: the motor cannot run on line power. The Grundfos CUE is the matched drive; for another brand, the motor data the drive needs is in the data booklet |
| Sine-wave filter |
An IPM-ready sine-wave filter is required on SPE pumps, sized on motor current at 120 Hz |
| Power |
460V 3Ph supply to the drive |
| Flow |
Do not run continuously below 0.1 × or above 1.3 × rated flow |
| Water quality |
Clean, thin liquids; max. sand content SPE 385S: 50 ppm; SPE 475S: 50 ppm |
| Water temperature |
Up to 140°F (60°C) with 0.5 ft/s flow past the motor |
| Duty point |
Choose the model from the Grundfos curve at your flow and total head. Send us the pumping level, pipe run and pressure and we will check it against the curve and size the drive |
Materials of Construction
| Part |
Material |
| Valve casing, chamber, impellers, suction interconnect, strainer, strap, cable guard |
Stainless steel AISI 304 |
| Valve cup |
Stainless steel AISI 316 (SPE 90S-300S); AISI 304 (SPE 385S-1100S) |
| Pump shaft |
Stainless steel AISI 431 |
| Neck ring, valve seat |
NBR-FKM |
| Bearing |
FKM-LSR (SPE 90S-300S); NBR-FKM (SPE 385S-1100S) |
| Motor sleeve and end shield (MS6000P) |
Stainless steel AISI 304 |
| Motor shaft |
Stainless steel AISI 431 |
| Motor shaft seal |
SiC/SiC |
| Motor rubber parts and diaphragm |
NBR |
| Motor radial / axial bearings |
Carbon/stainless steel; ceramic/carbon |
Source: Grundfos SPE data booklet, May 2026, standard version. N (AISI 316) and R (AISI 904L) versions are available to order for aggressive water.
